Home / Data centers by region / Texas (ERCOT)

Region · Texas · ERCOT

Texas data-center power & the ERCOT queue

No market shows the AI power crunch like Texas — where the interconnection queue is the real bottleneck, not the silicon.

A Gridlas analysis · ERCOT / LBNL / EIA data · current as of mid-2026 · Updated Oct 2026

63 → ~474 GW
large-load queue, end-2024 → Jun 2026
~90%
of the queue is data centers
<1%
of queued capacity actually drawing power

ERCOT's large-load interconnection queue went from 63 GW at the end of 2024 to roughly 226 GW by November 2025 — then doubled again, to about 474 GW by June 2026. Around 90% of that is data centers. Dallas–Fort Worth alone has crossed a gigawatt of operating supply.

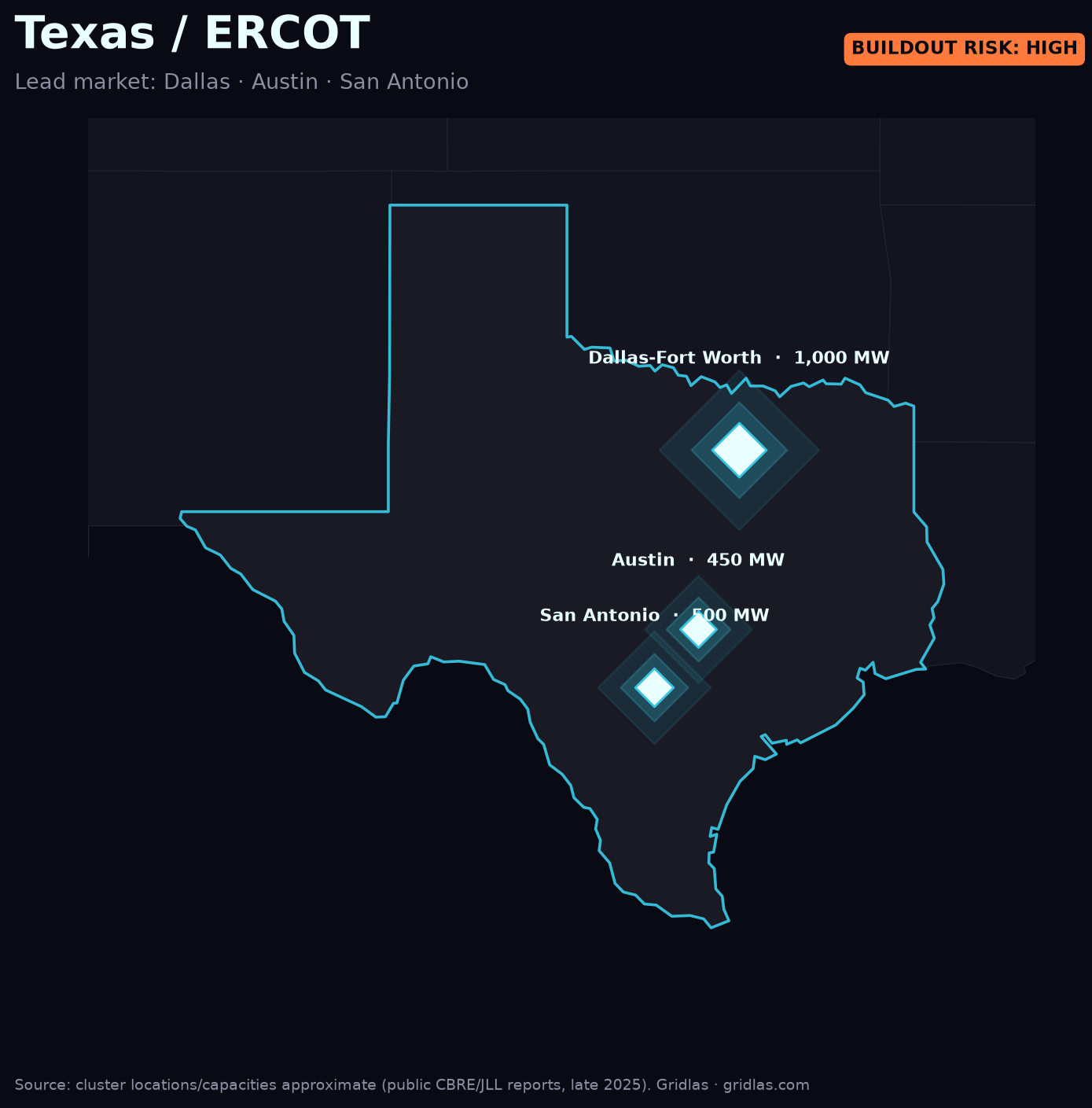

Map of Texas data-center clusters and power plants over the ERCOT grid
Texas data-center clusters and generation over the ERCOT grid. Source: public EIA / ERCOT (late 2025); clusters approximate.

But a queue is a wish list, not a build plan. Of those ~474 GW, only about 4.3 GW — under 1% — is actually drawing power, and about 9.5 GW (~2%) has approval to energize. ERCOT added roughly 23 GW of new generation in 2024–25, but the requests are arriving far faster than steel goes in the ground. In August 2026 the state stepped in: Gov. Abbott ordered an audit of data-center interconnection, and ERCOT paused its "Batch Zero" large-load study for months.

ERCOT large-load queue, June 2026: about 474 GW queued, about 9.5 GW approved to energize, about 4.3 GW drawing power
Queued ≠ built: how little of the ERCOT large-load queue is drawing power. Source: ERCOT, Texas Senate testimony (July 29, 2026).
Compute scales in months. Power scales in years. Texas is where that mismatch is most visible.

Why it matters

ERCOT's deregulated, fast-connect reputation is exactly why hyperscalers flooded in — and exactly why the queue is now the gating factor. For anyone siting capacity in Texas, the question has shifted from "can I get land and power?" to "where in the queue am I, and will the wires arrive before my GPUs do?"

Go deeper. The Gridlas report includes the full Texas deep-dive and high-res ERCOT queue maps — built from public ERCOT, LBNL & EIA data.

Get the report →

Need Texas in depth? A Market Power Brief covers one market and three you compete with, every figure cited. $850.

Prefer the free 3-page summary first? The 8 findings and the chart that explains the AI power crunch — straight to your inbox.

You’ll also get Power Watch, our free weekly digest of data-center power news, every Tuesday. No spam. Unsubscribe anytime.

Latest developments

Headlines from the past 30 days, updated Nov 18, 2026. Want these every week? The free summary signup below includes Power Watch, our Tuesday digest.

Frequently asked

How big is the Texas ERCOT large-load queue?

It grew from 63 GW at end-2024 to about 226 GW by Nov 2025, then more than doubled again to about 474 GW by June 2026. About 90% of the queue is data centers.

How much of the ERCOT queue is actually built?

Under 1%: only about 4.3 GW of the ~474 GW queue is actually drawing power, and about 9.5 GW (~2%) has approval to energize — compute scales in months, power in years.

Try the free power & water estimator on this market → · Share on X →

Big-picture overview: The Texas power rush →

Sources: ERCOT testimony to the Texas Senate, Jul 29 2026 (queue size, data-center share, energized load); earlier ERCOT interconnection & load reports (via Latitude Media / Utility Dive); LBNL "Queued Up" 2026; U.S. EIA (public domain). Figures current as of mid-2026. See the full methodology & sources.
Gridlas · independent & unaffiliated · built from public data. · Read the full analysis →
